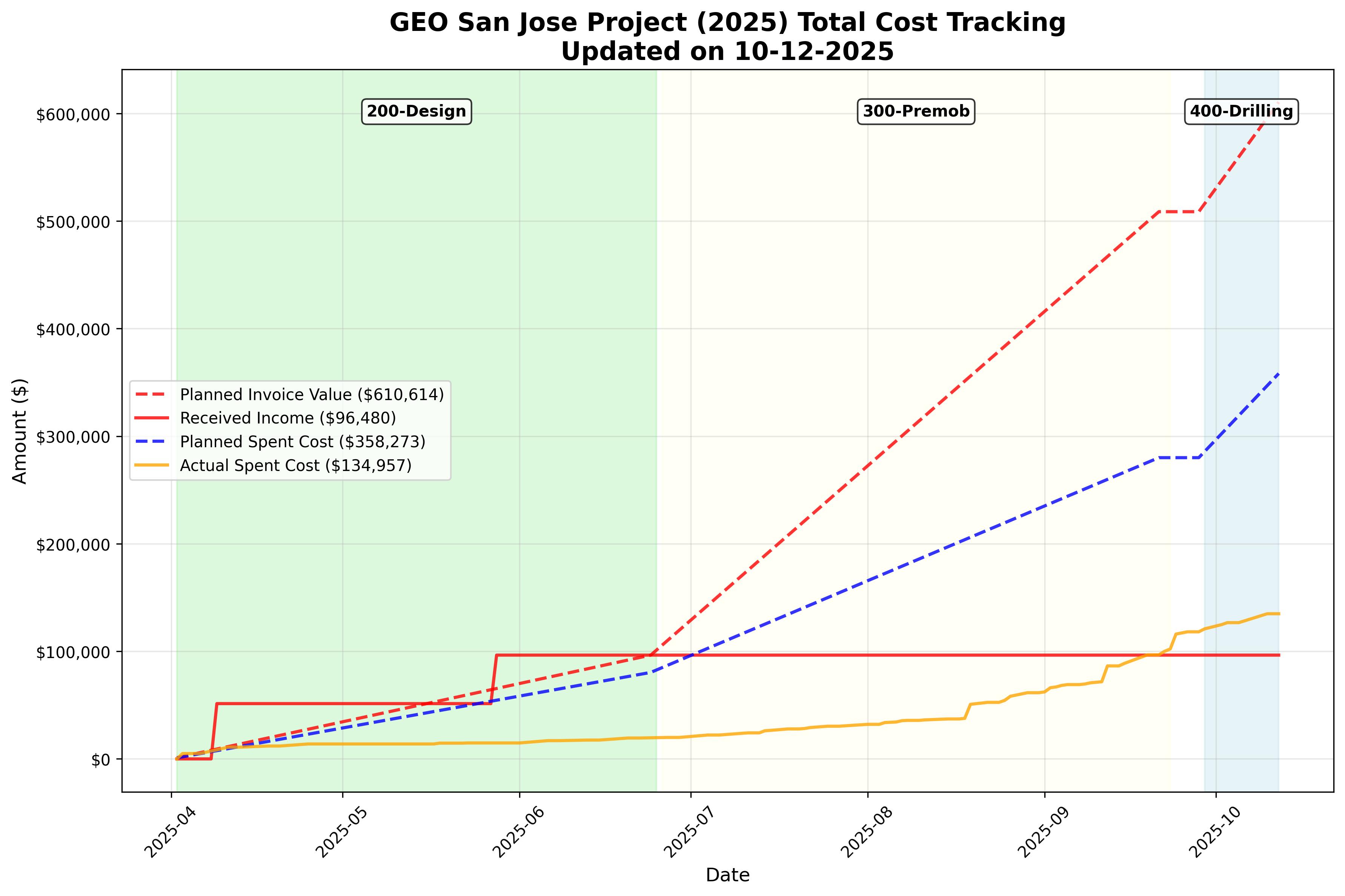

Invoice Value
Received Income:
$1,127,721 (66.4%)
Planned Cost
Planned Cost Sum:
$1,223,792
Actual Spent:
$462,494 (37.8%)
Summary
| Task ID |
Task Name |
Status |
Schedule |
Planned Duration |
Actual Duration |
Duration % |
Invoice |
Income Received |
Income % |
Planned Spend |
Actual Spend |
Spent Cost % |
Profit % |
Planned Labor Days |
Actual Labor Days |
Applied Labor % |
| 200 |
Design Activities |
Completed |
04/02/25 - 06/24/25 |
60 |
60 |
100% |
$96,480 |
$96,480 |
0% |
$80,400 |
$22,480 |
28% |
77% |
134 |
30 |
22% |
| 300 |
Pre-Mobilization |
Completed |
06/25/25 - 09/21/25 |
63 |
63 |
100% |
$412,231 |
$14,785 |
0% |
$199,649 |
$101,687 |
51% |
75% |
21 |
97 |

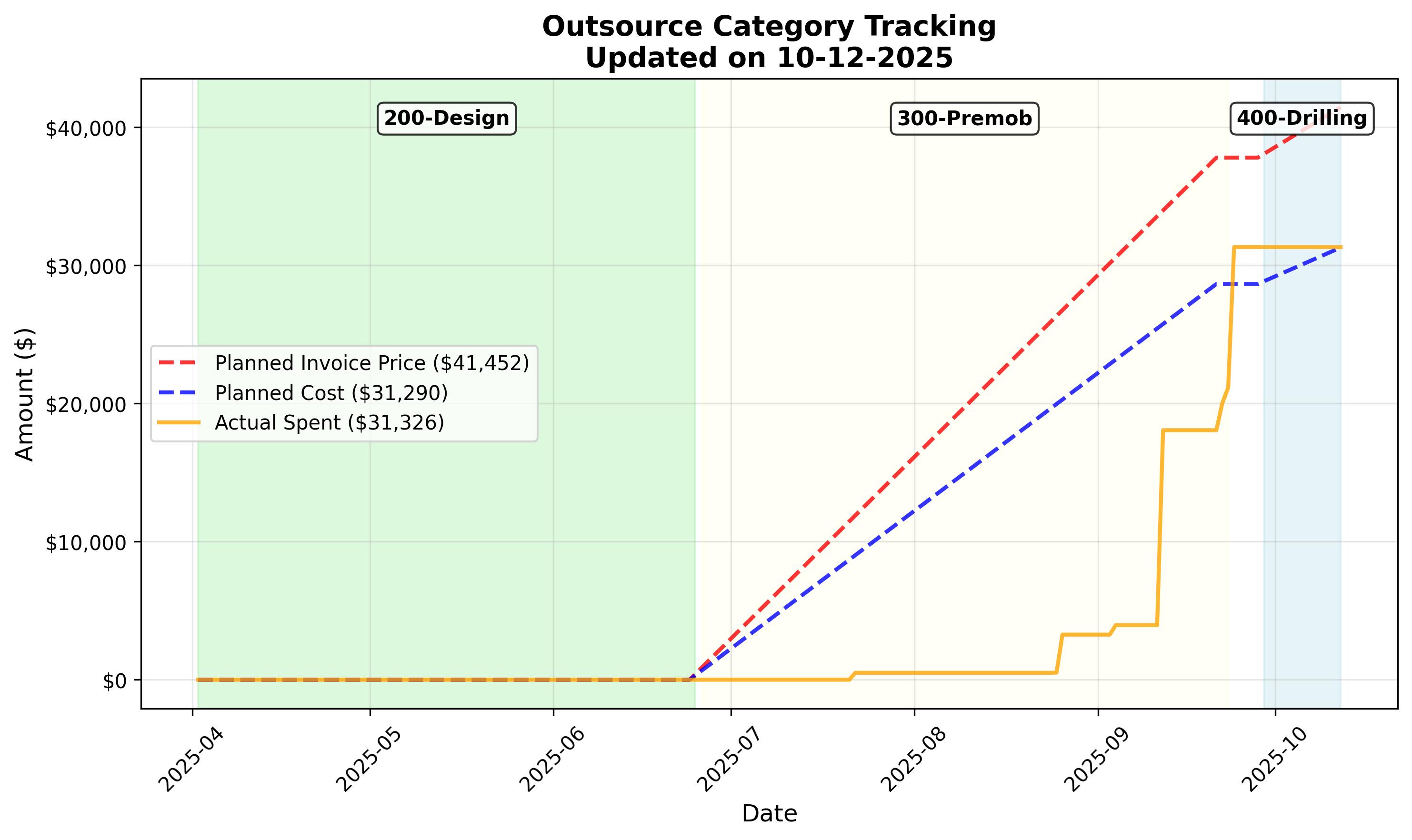

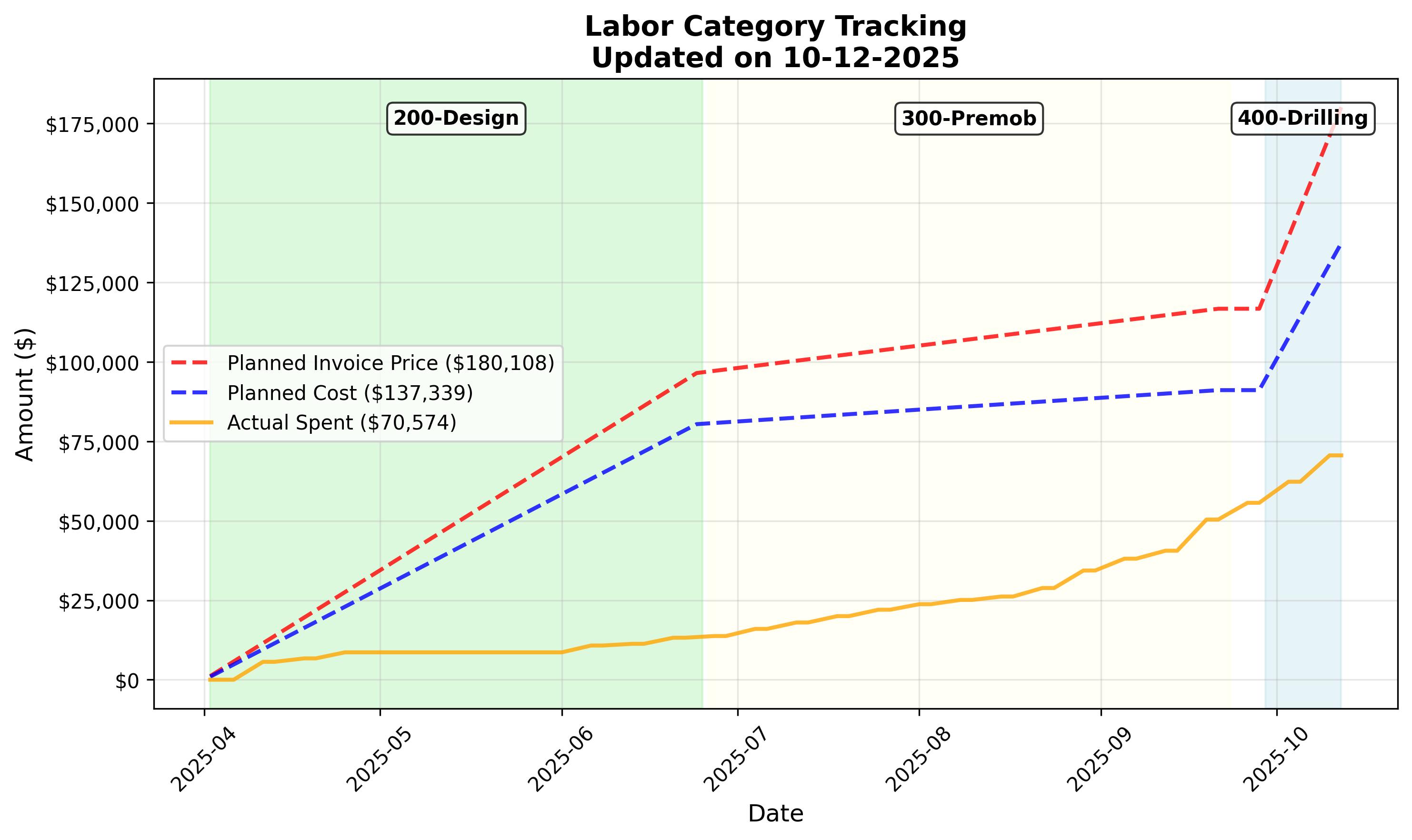

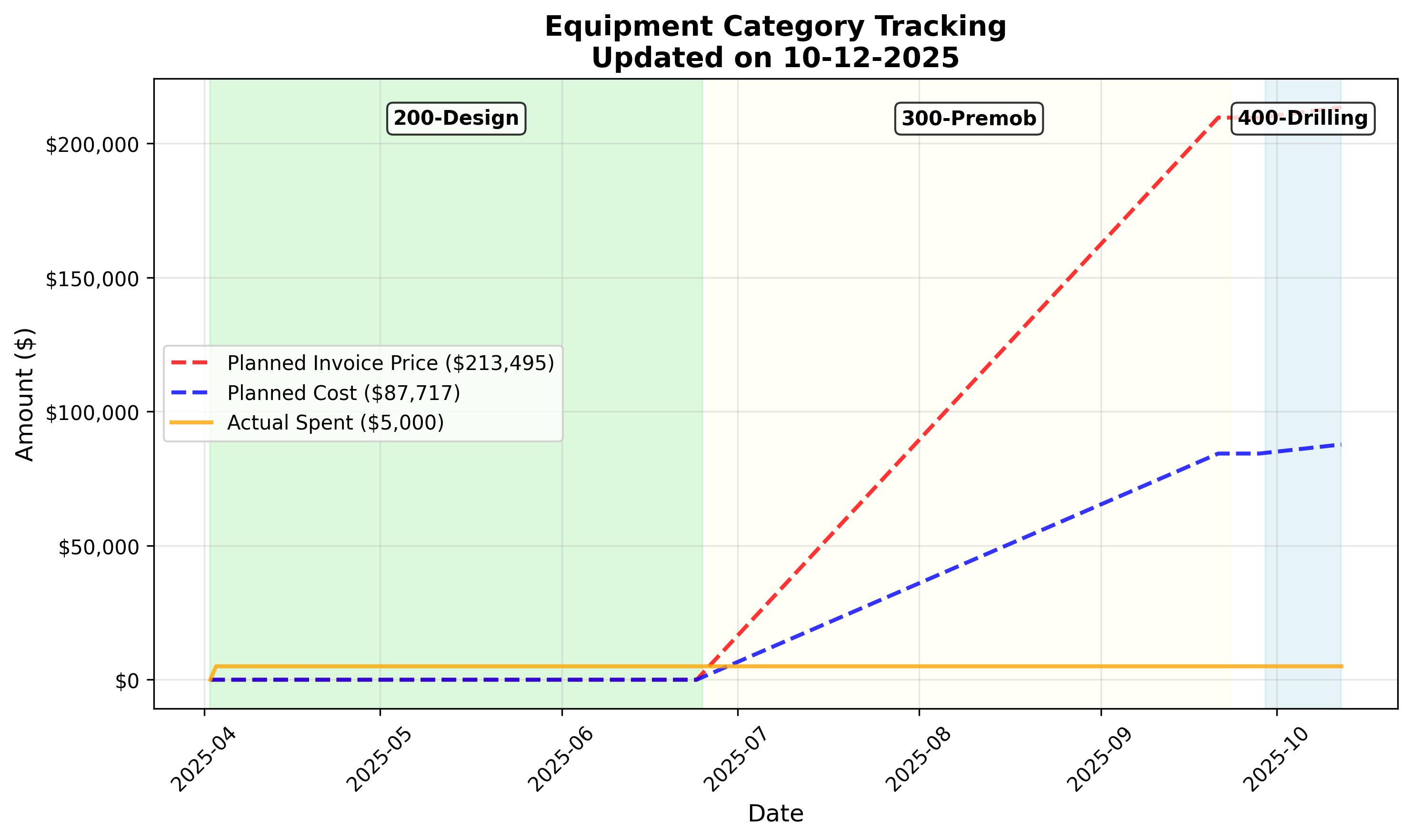

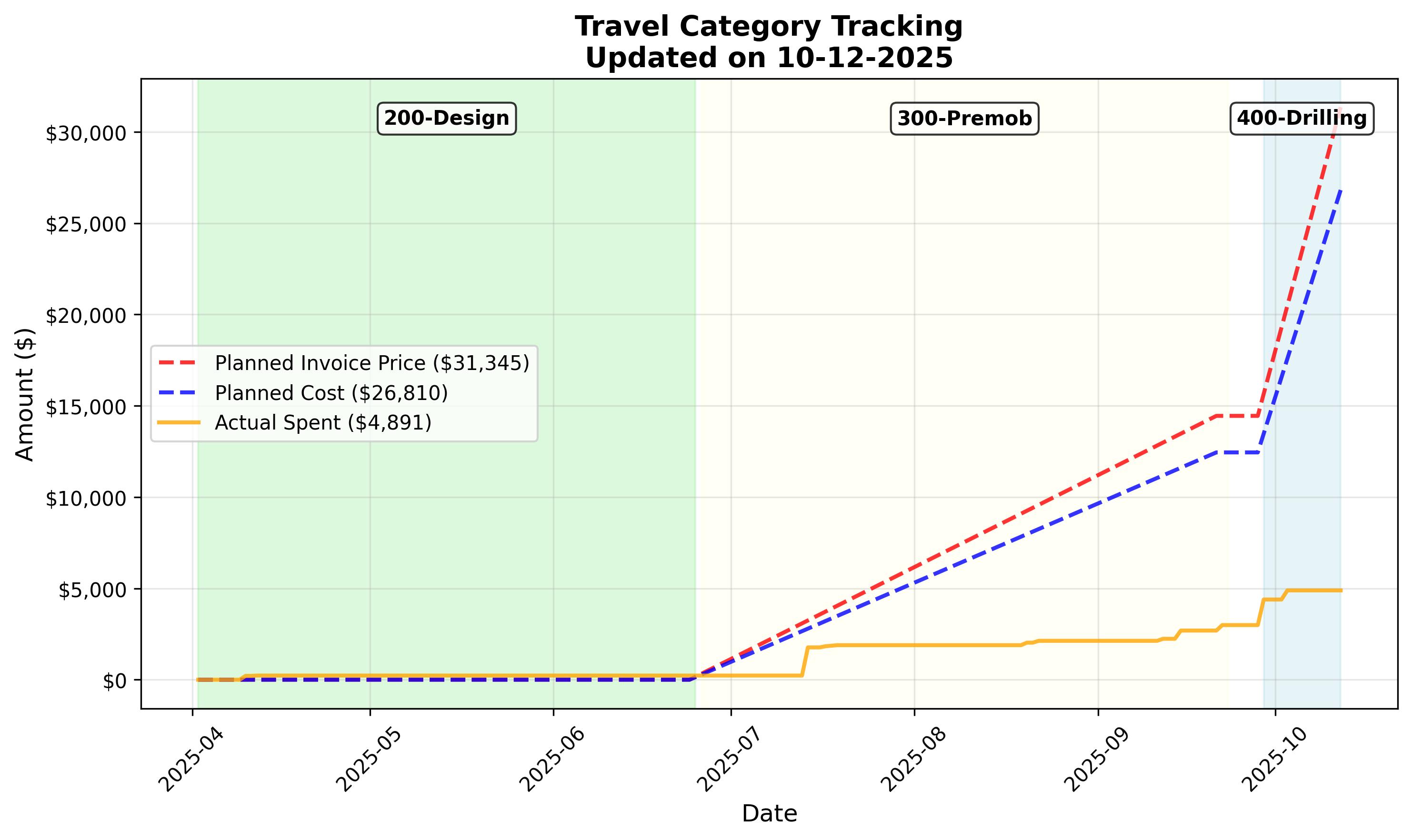

459% |
| 400 |
Drilling |
Completed |
09/23/25 - 11/13/25 |
38 |
38 |
100% |
$371,217 |
$665,464 |
0% |
$284,959 |
$169,749 |
60% |
54% |
316 |
114 |
36% |
| 500 |
Field Construction |
Completed |
11/14/25 - 03/02/26 |
109 |
77 |
71% |
$361,680 |
$235,100 |
0% |
$280,440 |
$167,239 |
60% |
54% |
288 |
165 |
56% |
| 600 |
Operation |
In Progress |
03/03/26 - 11/23/26 |
190 |

13 |
7% |
$376,851 |
$115,892 |
0% |
$313,383 |
$10,450 |
3% |
97% |
370 |
13 |
4% |
| 700 |
Demobilization |
Future |
11/24/26 - 12/25/26 |
24 |
N/A |
0% |
$78,953 |
$0 |
0% |
$64,961 |
$0 |
0% |
0% |
98 |
0 |
0% |
| TOTAL |
|
|
04/02/25 - 12/25/26 |
633 |
197 |
31% |

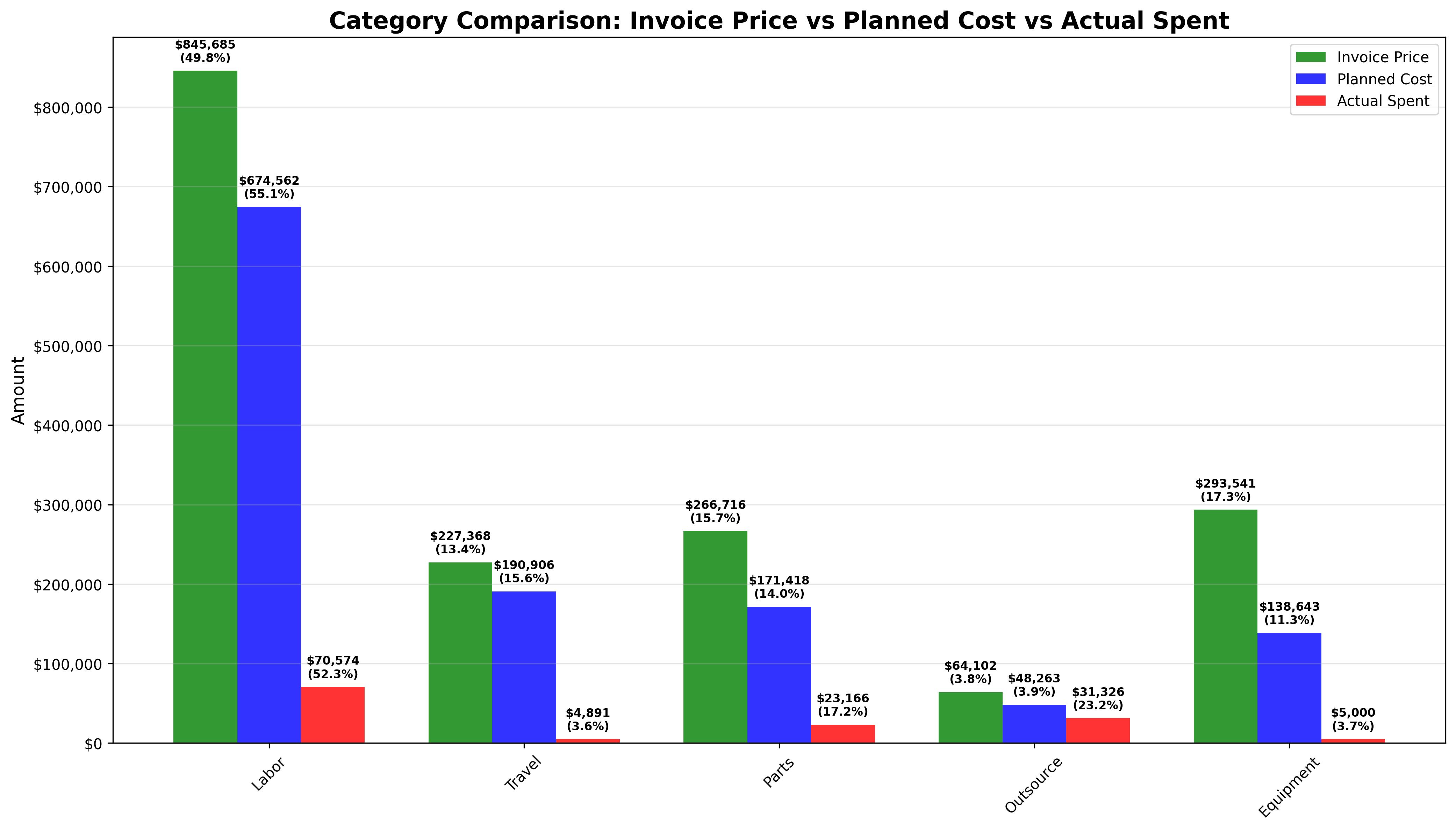

$1,697,412 |
$1,127,721 |
66% |
$1,223,792 |
$471,606 |
38% |
139% |
1227 |
418 |
34% |
Download Detailed Reports
